The Neutral Trend In The Most Reliable Long Leading Indicators In Housing Continues

Housing permits and starts reached a neutral trend in July, so this long leading indicator is no longer signaling a recession.

Source: DepositPhotos

Let me start out this post with my updated overall conception of the long leading indicators. To begin with, most of them are financial — generally speaking, “the cost of money.” That applies to bond interest rates, the yield curve, real money supply, and bank lending. Recently, I’ve also indicated that fiscal policy should be added, as in, is there a major stimulus or austerity at work? But it is increasingly apparent that a recession does not occur until after the “real world,” non-financial long leading indicators also participate: corporate profits, real retail sales per capita, and - drum roll, please - housing permits and starts.
Because although permits and starts are very much downstream of mortgage interest rates, they represent activity in the sector that constitutes the biggest consumer purchase of all, and through construction, landscaping, and furnishing, typically take around 2 years to fully filter through into the broader economy.

So let’s look at the numbers. To begin with, I no longer measure against the big 2022 interest rates hikes, because those have fully worked through the system. Thus almost all the graphs below are limited to the last three years. In the last several months I have written at length about how the entire housing market had reached an equilibrium, where almost all of the metrics were more or less flat.

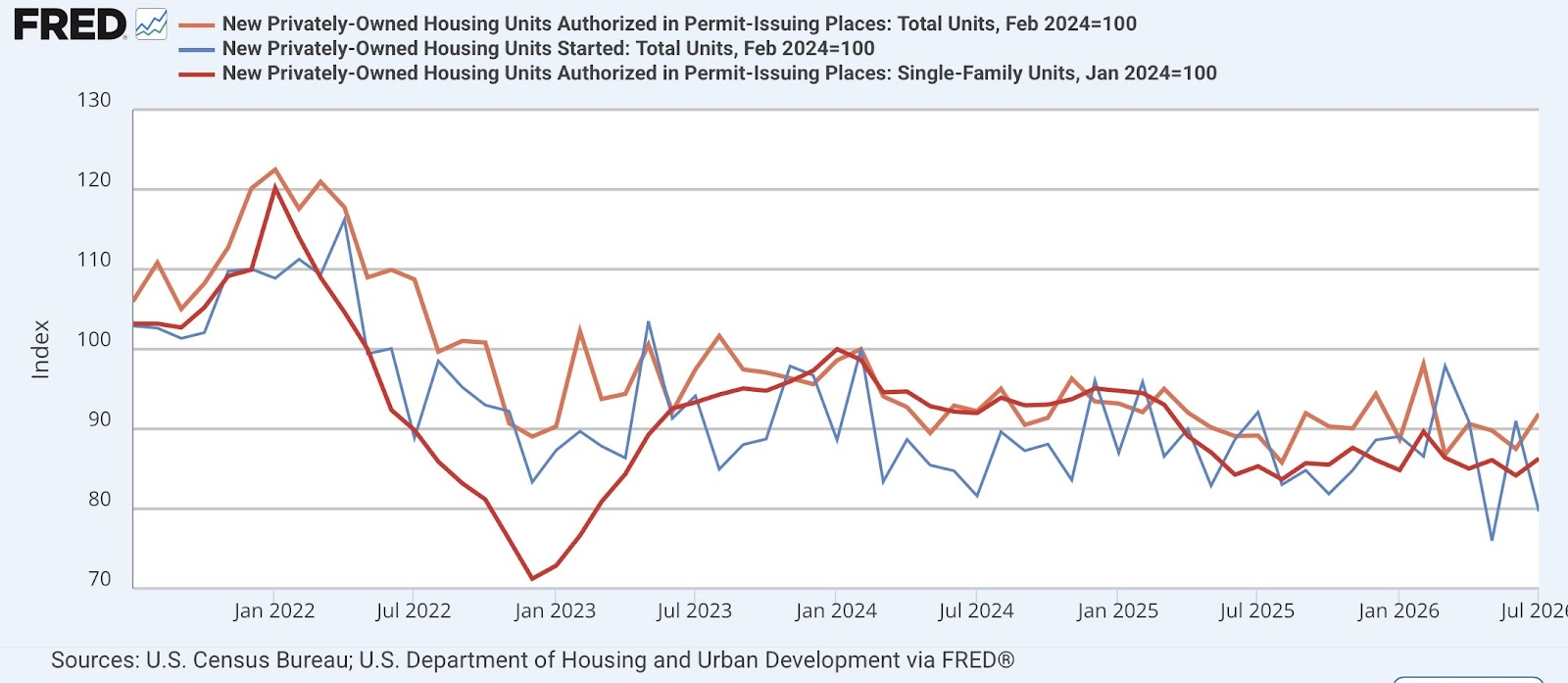

This morning’s data on housing permits, starts, and units under construction for July continued that trend. Housing permits (blue) issued rose 69,000 to 1.443 million annualized, while the much more volatile number of starts (gold) declined -176,000 to 1.239 million annualized. Single family permits (red, right scale), which are the least volatile metric conveying the most signal, rose 22,000 to 894,000 annualized. The below graph shows each of them in comparison with their high water marks of the last several years, January and February of 2024:

Since that time, permits are off -8.1%, single family permits off -13.7%, and the three month average of starts off -17.8%. But perhaps more importantly, the stabilization of permits and starts slightly lower than their 2023-24 levels in the past 12 months is apparent.

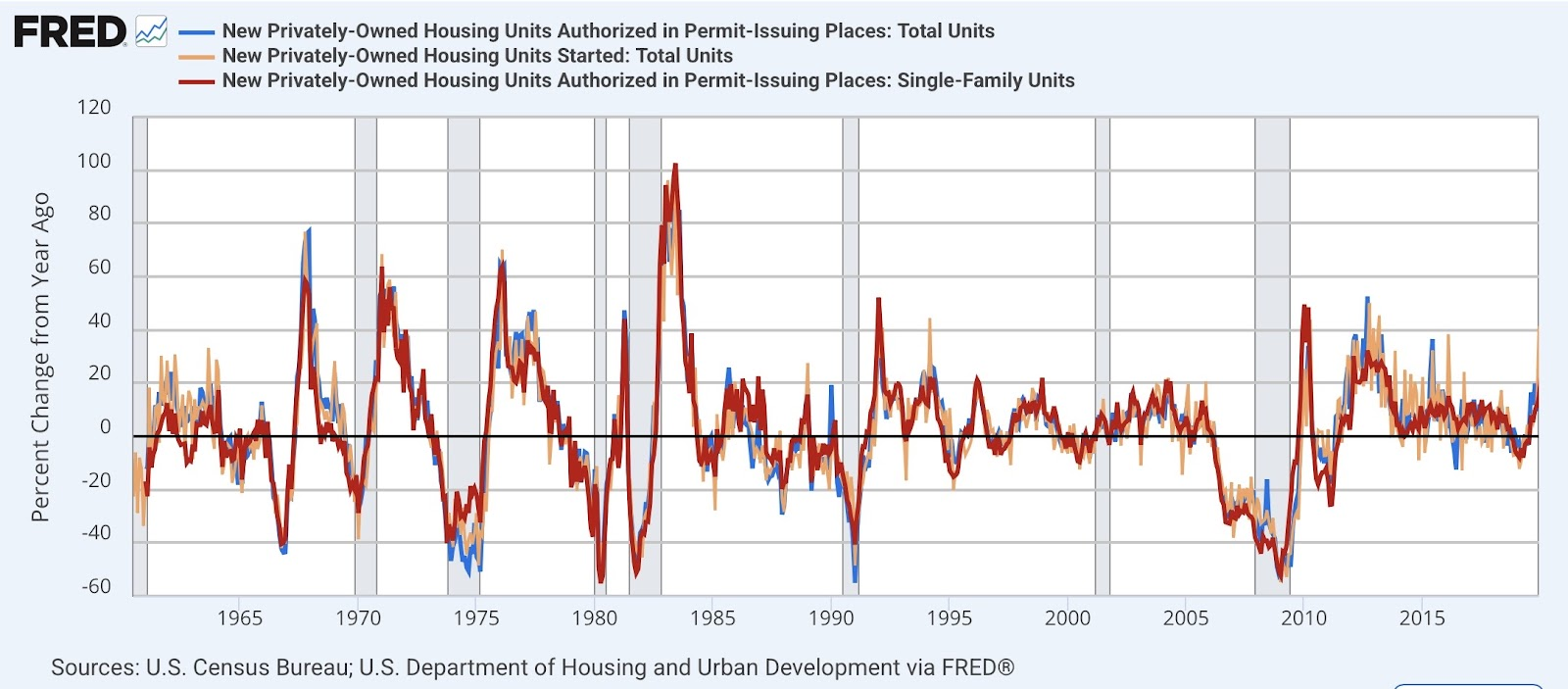

In that vein, for me to consider housing recessionary, I would expect to see all three off at least -10% from recent highs, but also as the below historical graph shows, down -10% or more YoY:

Note that single family permits has turned positive YoY no later than 5 months after the end of any recession in the past 50+ years.

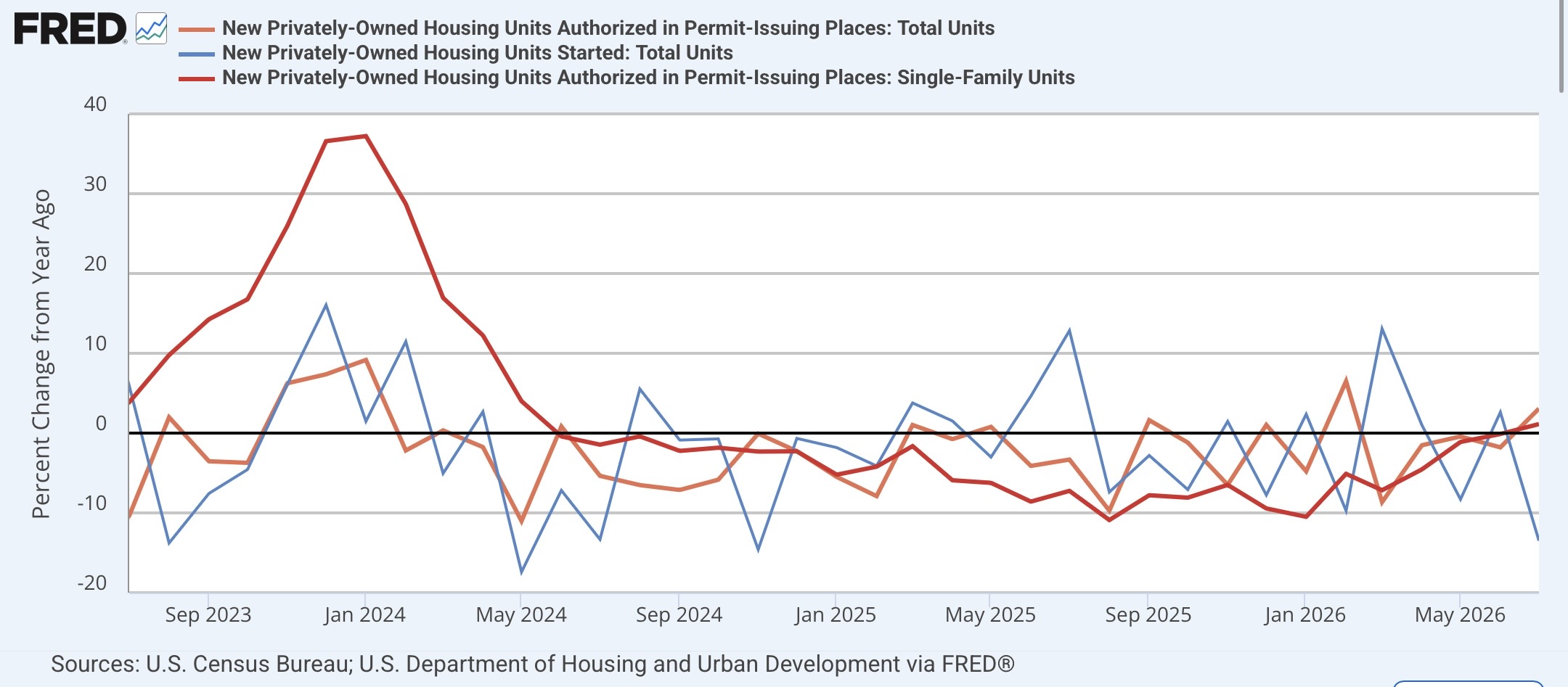

But as the below graph of the last three years shows, not only are these metrics no longer down more than -10% YoY, but two of the three are positive, as permits are up +3.1% YoY, single family permits up to+1/1%, and only starts down -13.8% (-6.4% for the three month moving average):

This is no longer recessionary.

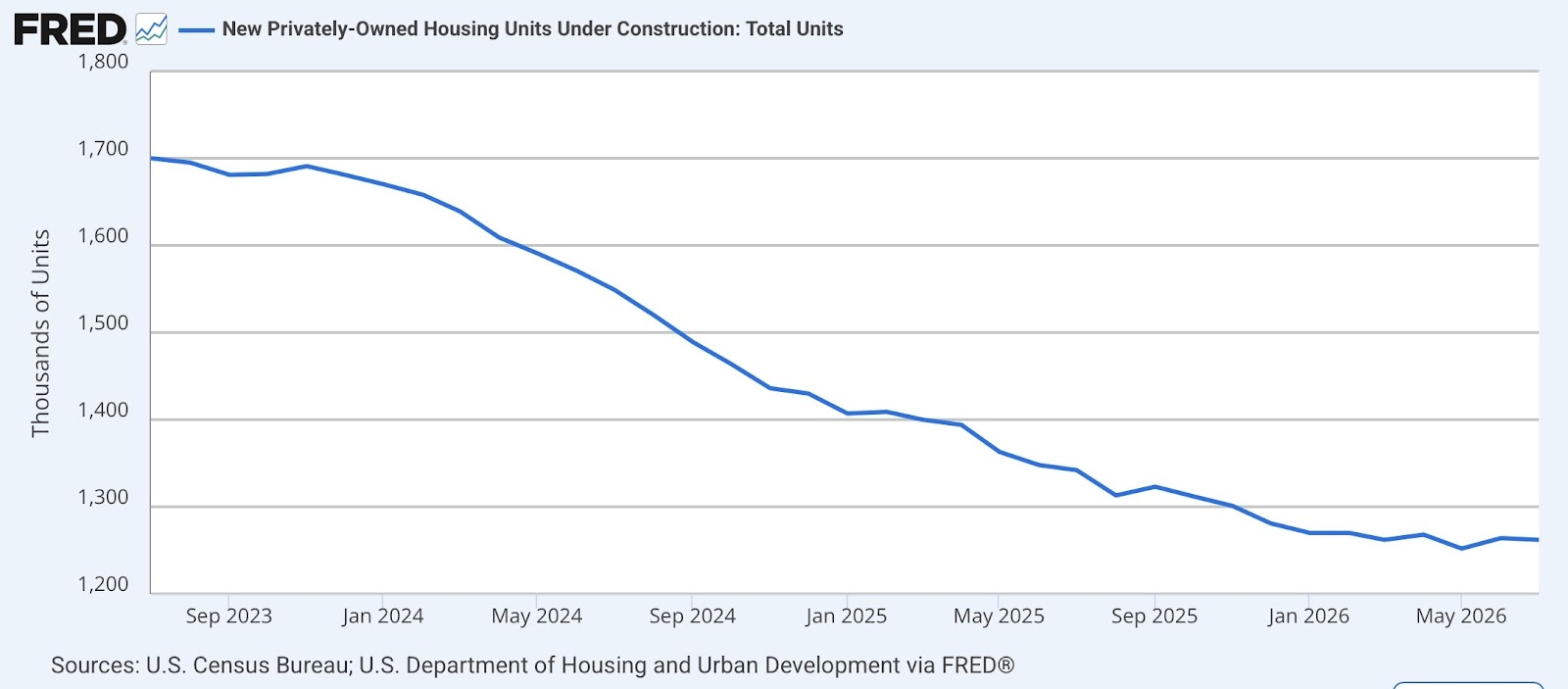

Last year I was calling housing units under construction the “last shoe to drop;” and after a plateau in 2022-23, it had been dropping like a rock, as shown in the graph below. But then it too started to stabilize, as this series has been virtually unchanged for the past seven months:

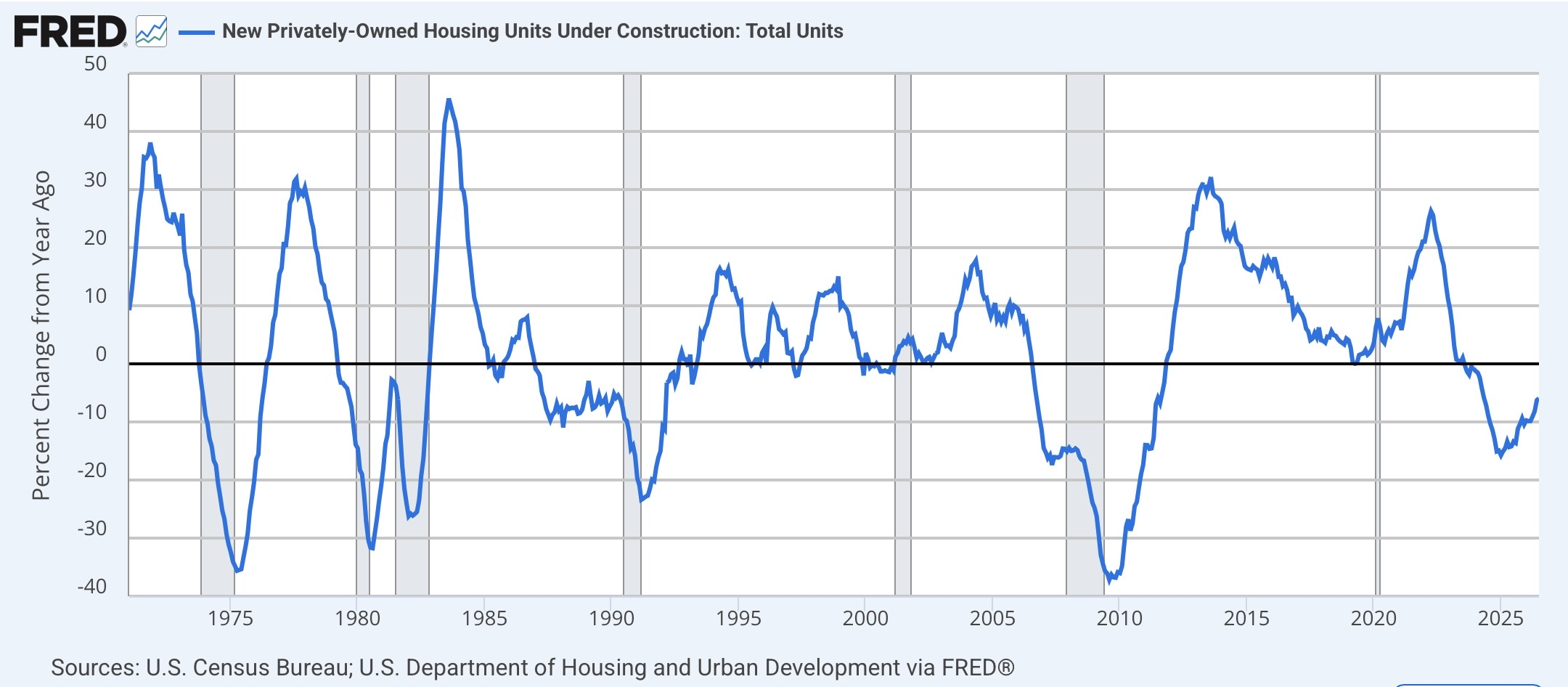

And the below historical graph is what really grabbed my attention, because in the past it has only flattened out, and started to improve on a YoY basis, only at the end of recessions and beginnings of expansions. And that is exactly what the YoY comparison shows now:

Units under construction are still down -6.0% YoY, but this is the best YoY comparison in 24 months. This is most consistent with a rebound after a recession.

To sum up, residential construction metrics in July continued the sideways trend, of a subpar housing equilibrium — but an equilibrium that nevertheless means this long leading indicators for the economy is no longer recessionary, but neutral.
